Aluminium Window Installation

Aluminium window installation is a precision-based process that involves fixing a pre-fabricated aluminium frame and glass system into a prepared wall opening. Proper installation ensures airtight sealing, structural stability, water resistance, and long-term durability.

Unlike traditional wood or steel windows, aluminium systems require accurate alignment, chemical anchoring, and sealing techniques to perform effectively.

Types of Aluminium Windows (Before Installation):-

Understanding window type is critical because installation varies:

  • Sliding Windows

  • Casement Windows

  • Fixed Windows

  • Tilt & Turn Windows

  • Openable + Fixed Combination Windows

Tools & Materials Required:-
🔧 Tools
  • Measuring tape

  • Spirit level

  • Laser level (advanced)

  • Drill machine

  • Screwdriver set

  • Hammer

  • Rubber mallet

  • Glass suction lifter

  • Sealant gun

🧱 Materials
  • Aluminium window frame

  • Glass panels

  • Anchor fasteners / screws

  • Silicone sealant

  • PU foam / gap filler

  • Rubber beading

  • Packers (plastic spacers)

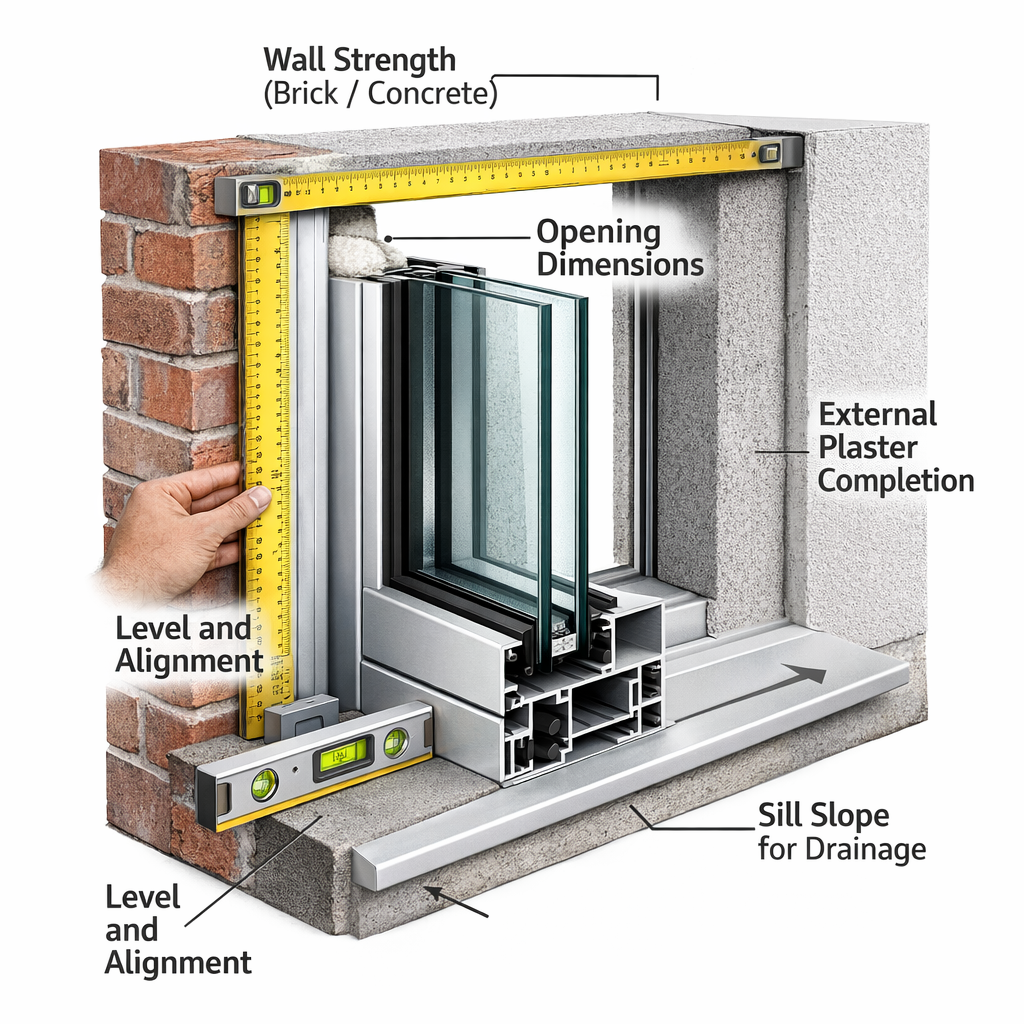

Site Inspection & Planning:-

Description

Before installation, the site must be inspected to ensure the opening is structurally ready.

Checklist
  • Wall strength (brick / concrete)

  • Opening dimensions

  • Level and alignment

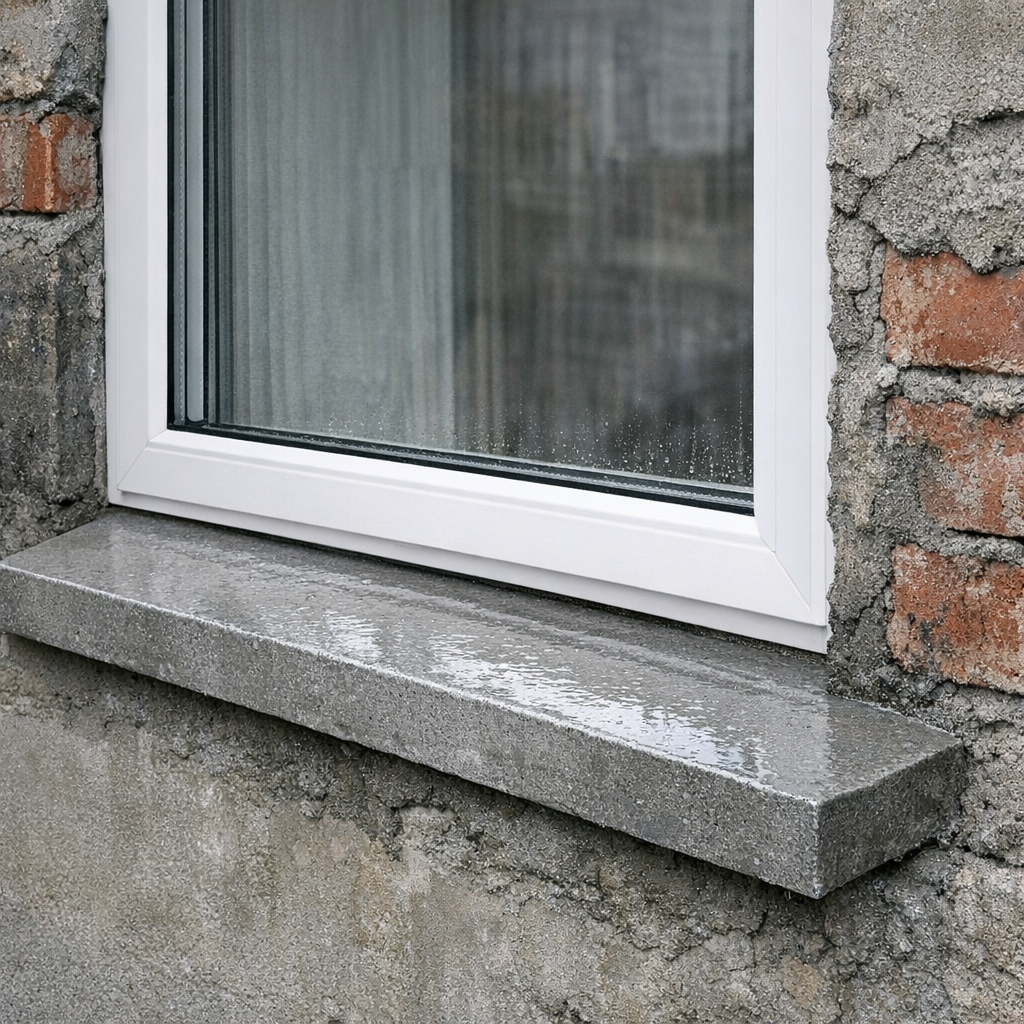

  • External plaster completion

  • Sill slope for drainage

Measurement of Window Opening:-

Key Rule:

👉 “Measure twice, install once”

Measurements Required:
  • Width (top, middle, bottom)

  • Height (left, center, right)

  • Diagonal check (for squareness)

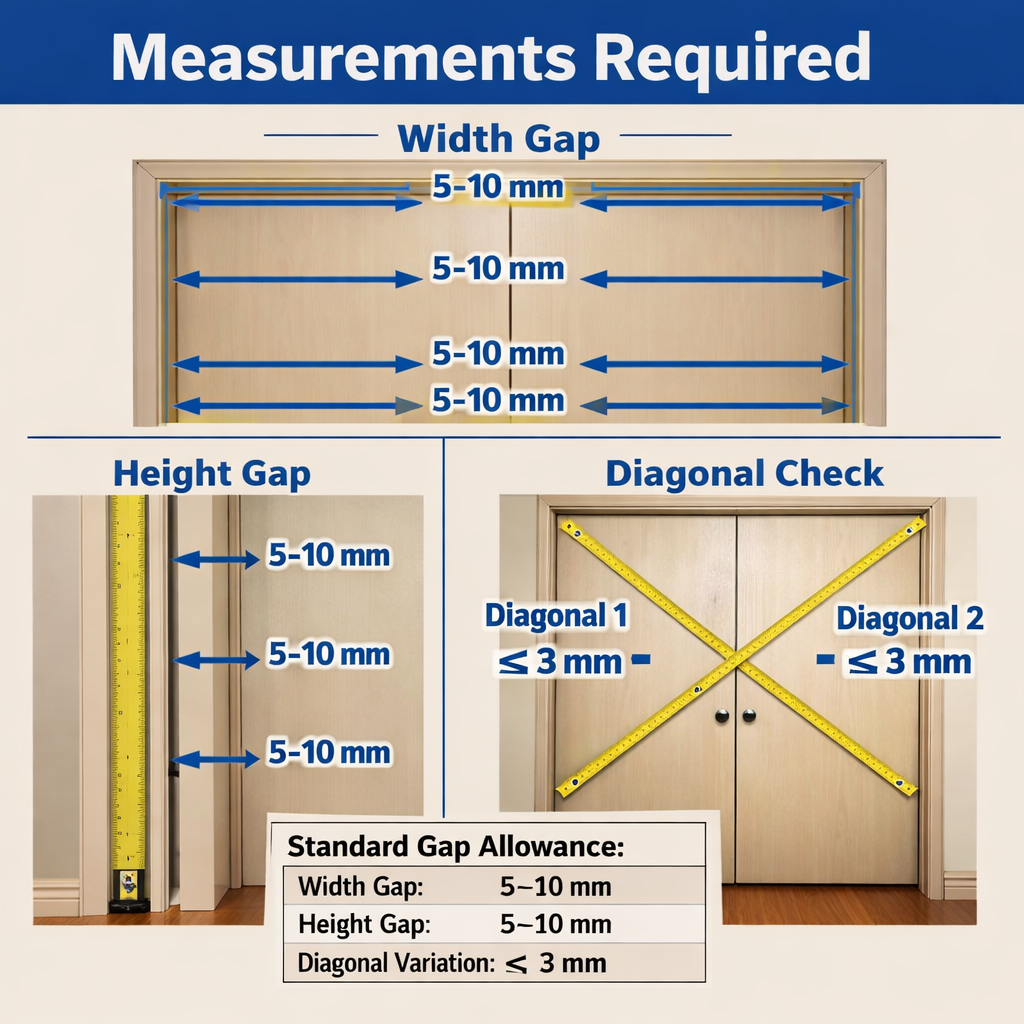

Standard Gap Allowance:
ParameterRecommended Gap
Width gap5–10 mm
Height gap5–10 mm
Diagonal variation≤ 3 mm

Surface Preparation:-
Description:-

The wall opening must be cleaned and prepared.

Steps:-
  • Remove dust, debris, loose plaster

  • Wet the surface slightly (for bonding)

  • Check sill slope (outward angle)

Frame Unpacking & Inspection:-

Check for:
  • Scratches or dents

  • Frame squareness

  • Proper corner joints

  • Accessories availability

Dry Fit Trial:-

Purpose:
  • To verify fit before final fixing

Steps:

  • Place frame inside opening

  • Check alignment and gaps

  • Mark fixing points

Frame Positioning:-

Alignment Rules:
  • Vertical (plumb)

  • Horizontal (level)

  • Square (equal diagonals)

Use:
  • Spirit level

  • Laser level (advanced accuracy)

Drilling & Anchor Fixing:-

Steps:
  • Drill holes in frame

  • Mark wall positions

  • Drill wall

  • Insert anchor fasteners

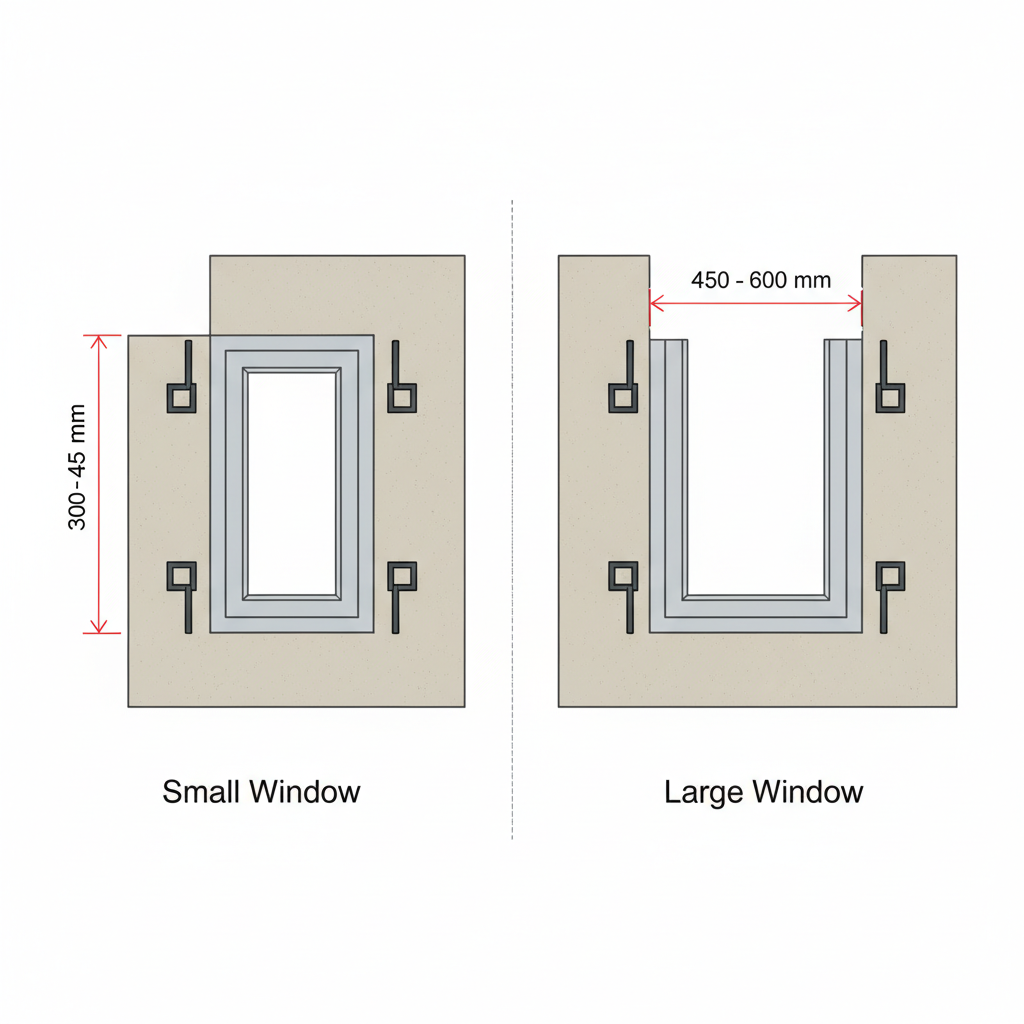

Anchor Spacing :-
Frame SizeAnchor Distance
Small window300–450 mm
Large window450–600 mm

Permanent Frame Fixing:-

  • Tighten screws gradually

  • Avoid over-tightening (frame bending risk)

  • Re-check alignment after fixing

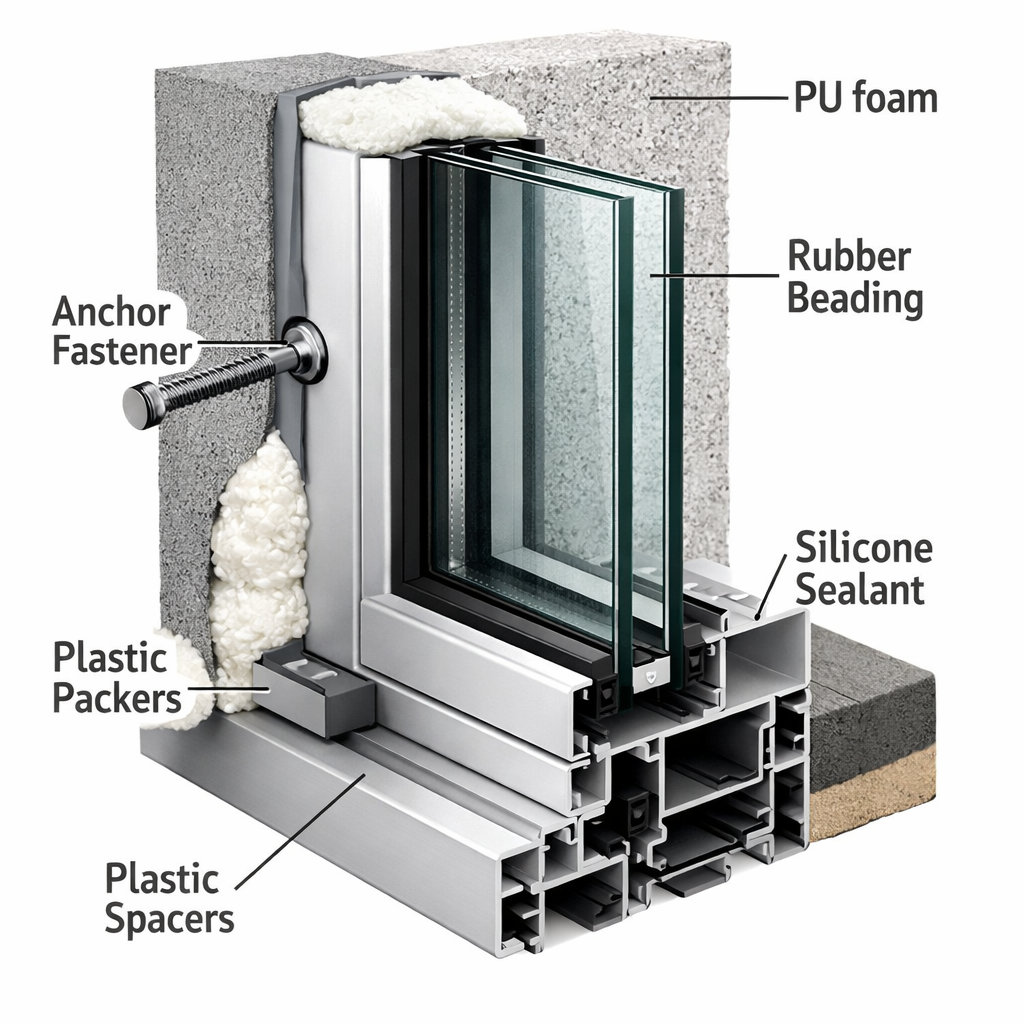

Gap Filling (Critical Step):-
Materials Used:
  • PU Foam

  • Cement mortar (rare)

Process:
  • Fill gap evenly

  • Avoid overfilling

  • Allow curing

Waterproof Sealing:-

Material:
  • Silicone sealant

Areas:
  • Outer perimeter

  • Bottom sill joint

Purpose:
  • Prevent water leakage

  • Improve insulation

Glass Installation:-
Steps:

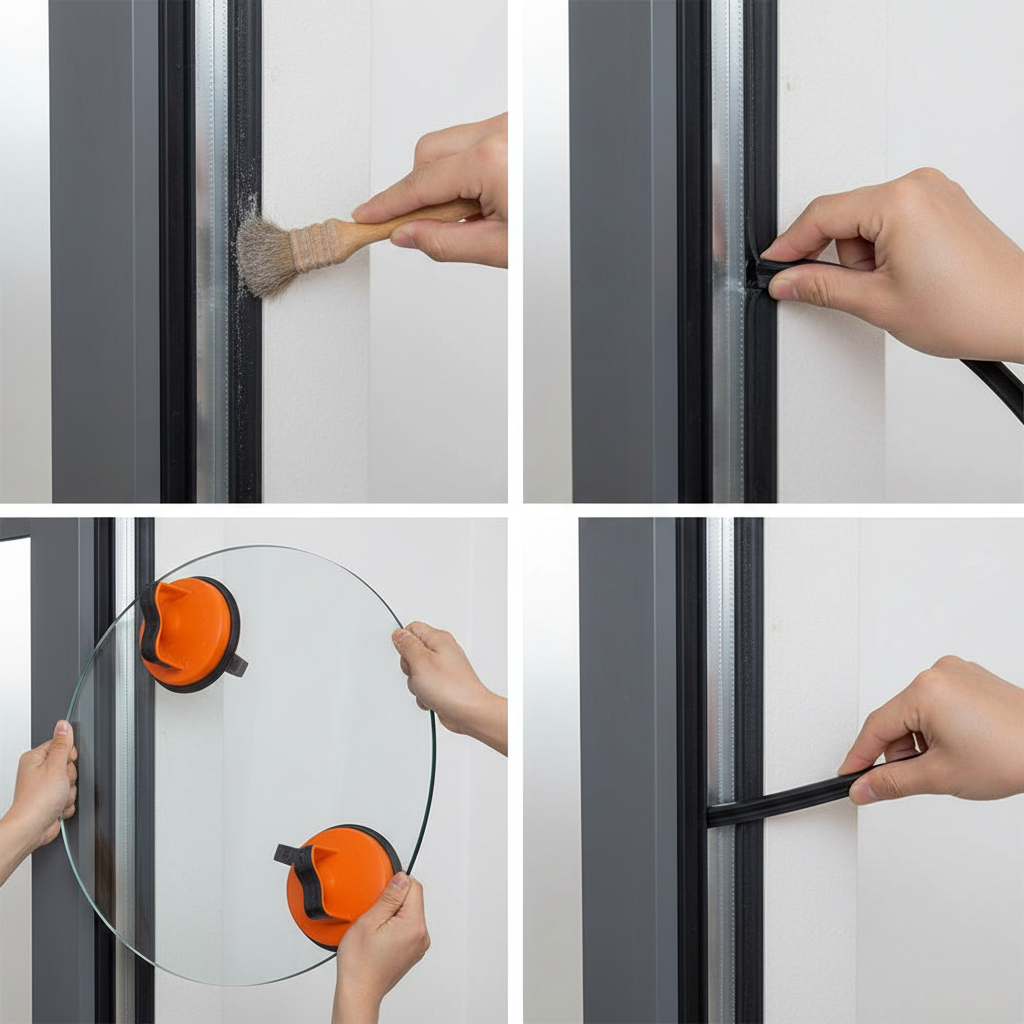

  • Clean frame grooves

  • Place rubber gasket

  • Install glass using suction tool

  • Fix with beading

Beading Fixing:-

Description:

Beading holds glass in position.

Types:

  • Clip-on beading

  • Screw-fixed beading

Hardware Installation:-

Includes:

  • Handles

  • Locks

  • Hinges

  • Rollers (sliding windows)

Sliding Track Alignment (For Sliding Windows):-

Ensure:

  • Smooth movement

  • No friction

  • Proper roller adjustment

Final Sealing & Finishing:-

  • Apply outer silicone finishing

  • Smooth edges

  • Clean excess material

Cleaning Process:-

  • Remove protective film

  • Clean glass

  • Polish aluminium frame

Quality Inspection Checklist:-

✔ Frame alignment
✔ Smooth operation
✔ No air gaps
✔ Proper sealing
✔ Lock functionality

Advanced Installation Techniques:-

  • Laser leveling systems

  • Chemical anchoring

  • Double sealing system

  • Thermal break installation

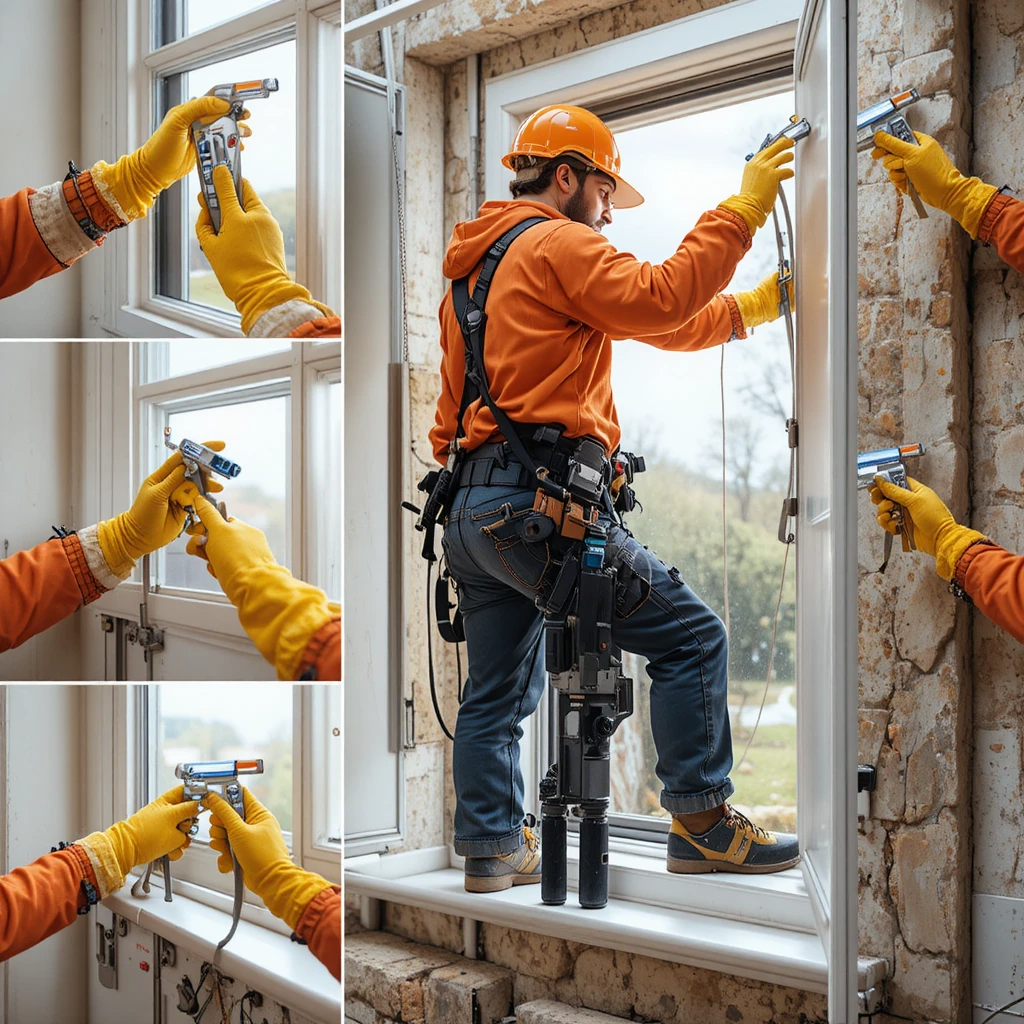

Safety Measures:-

  • Use gloves

  • Use safety shoes

  • Avoid working at height without harness

Time Required:-

Window TypeInstallation Time
Small1–2 hours
Medium2–4 hours
Large4–6 hours

Cost Factors:-

  • Window size

  • Glass type

  • Labour charges

  • Location

Maintenance After Installation:-

  • Clean tracks regularly

  • Lubricate rollers

  • Check sealant annually

Durability & Lifespan:-

  • Aluminium frame: 20–30 years

  • Sealant: 5–10 years

  • Hardware: 5–15 years

Installation Flow Summary:-

  1. Site inspection

  2. Measurement

  3. Surface prep

  4. Frame placement

  5. Fixing

  6. Sealing

  7. Glass installation

  8. Final inspection

Professional Tips:

  • Always allow expansion gap

  • Use branded sealant

  • Prefer powder-coated aluminium

  • Ensure proper drainage

Process 1: Site Inspection:-

  1. Measuring wall opening

  2. Checking level

  3. Inspecting wall strength

  4. Checking sill slope

  5. Marking installation area

  6. Identifying obstacles

  7. External wall condition

  8. Internal wall condition

  9. Tools preparation

  10. Planning layout

Process 2: Measurement:-

  1. Width measurement

  2. Height measurement

  3. Diagonal measurement

  4. Tape usage

  5. Marking points

  6. Recording dimensions

  7. Checking variation

  8. Double verification

  9. Frame comparison

  10. Final measurement sheet

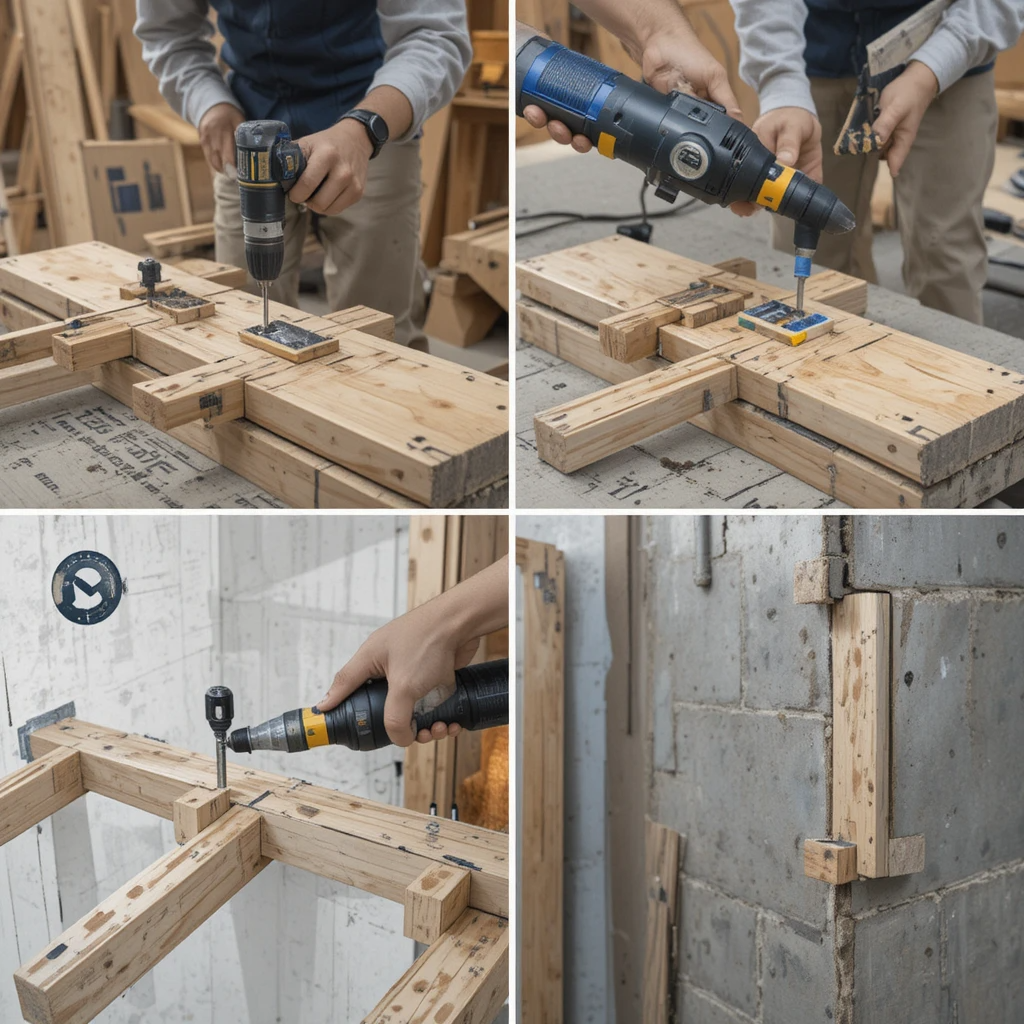

Process 3: Frame Fixing:-

  1. Frame placement

  2. Using packers

  3. Level checking

  4. Drilling frame

  5. Drilling wall

  6. Anchor insertion

  7. Screw tightening

  8. Alignment check

  9. Gap checking

  10. Fixed frame

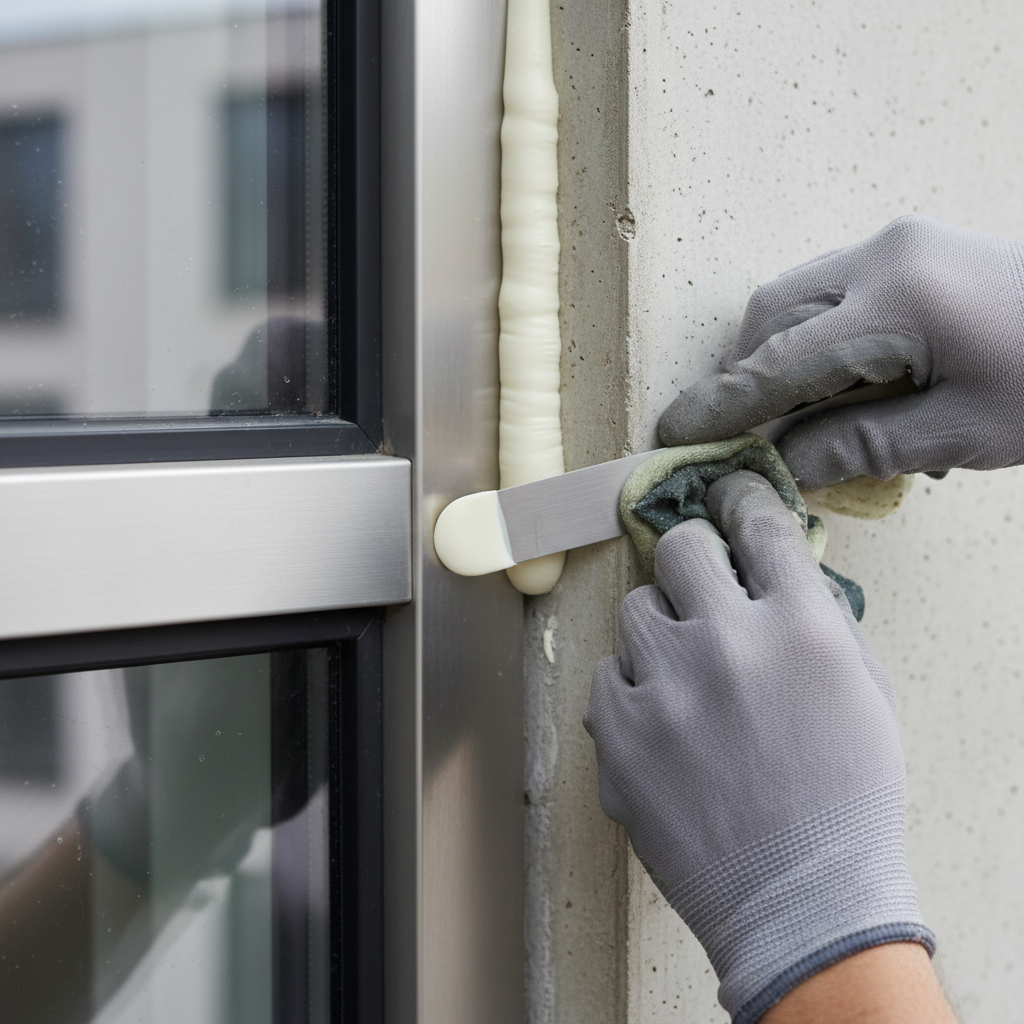

Process 4: Sealing & Finishing:-

  1. PU foam filling

  2. Gap sealing

  3. Silicone application

  4. Smoothing sealant

  5. Outer sealing

  6. Waterproofing

  7. Cleaning excess

  8. Final finishing

  9. Edge smoothing

  10. Completed seal

Process 5: Glass Installation:-

  1. Glass lifting

  2. Gasket placement

  3. Glass positioning

  4. Beading fixing

  5. Frame locking

  6. Checking alignment

  7. Cleaning glass

  8. Final inspection

  9. Smooth finish

  10. Installed wind
